States flow
For sprint issues

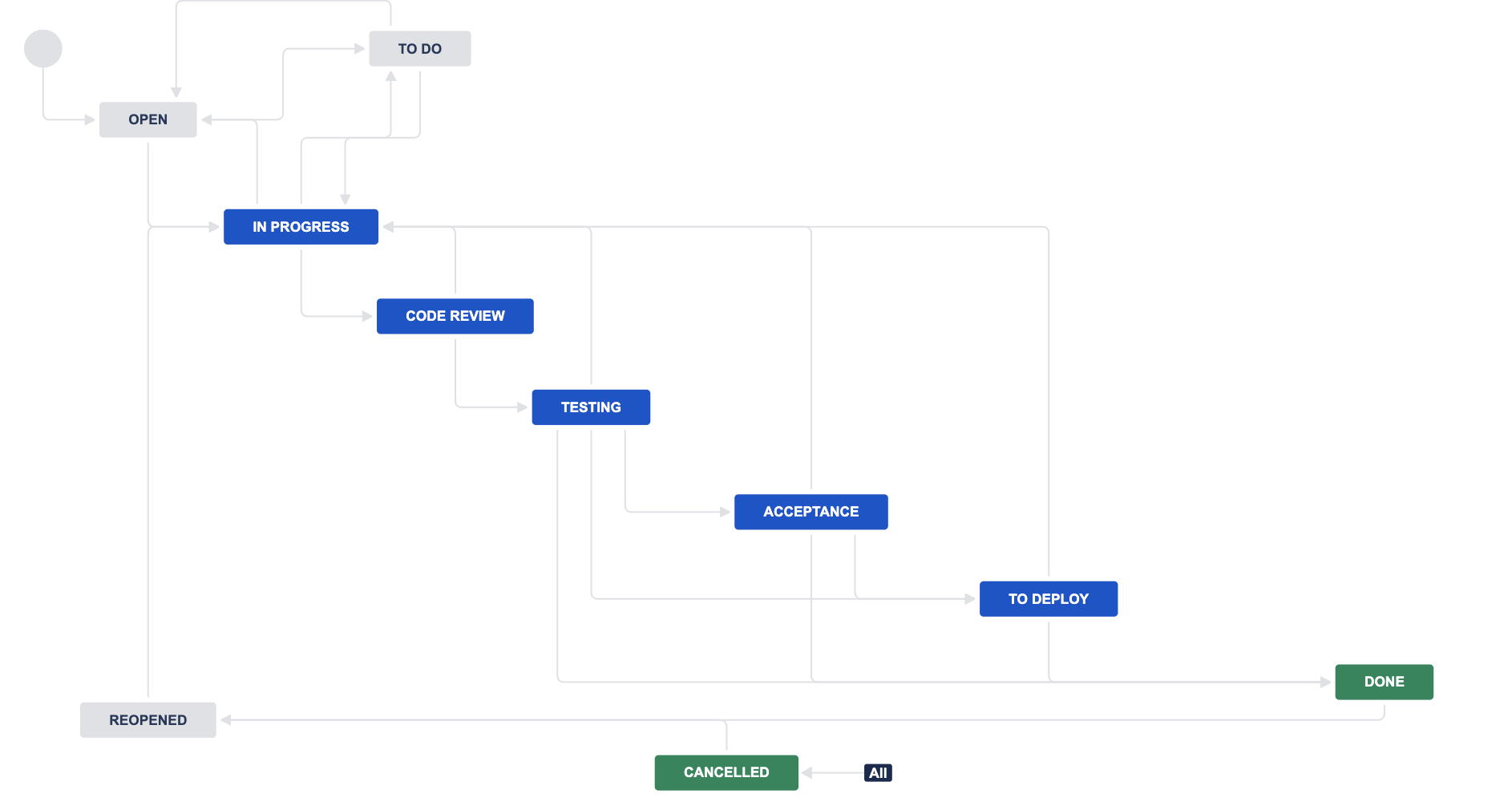

Cycle time encloses following states:
- in progress/development = start state
- code review
- testing
- acceptance
- deployed
- done = termination state
In general, we want to keep an average cycle time of issues around 5-6 days.
For epics
Epic cycle time is calculated as duration of en epic in Implementation or InProgress state.

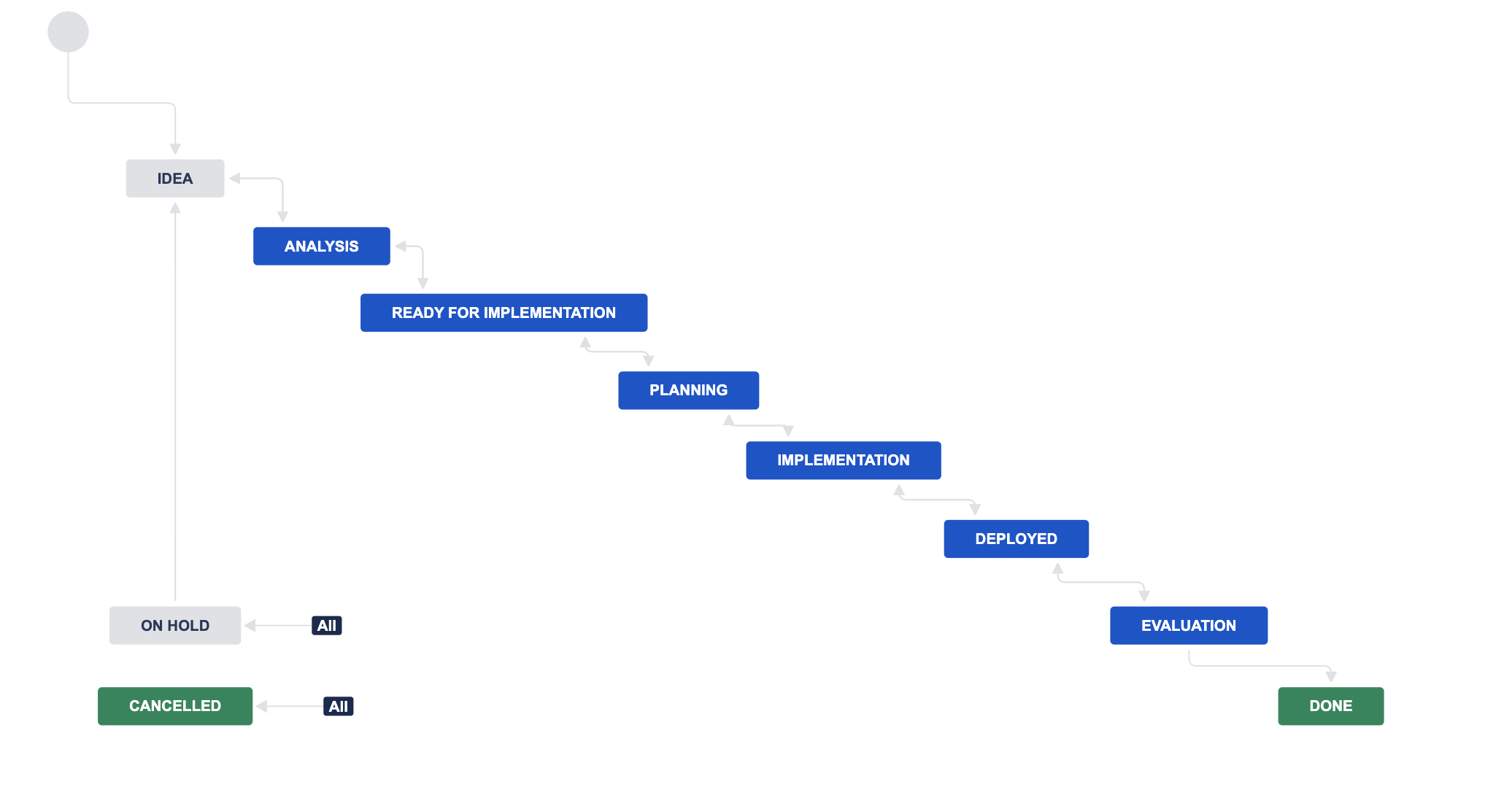

Translation of epic states
case
2
when "status_name" in ('Idea','Backlog','To Do') then 'Backlog'
3
when "status_name" in ('Evaluation','Analysis','Planning') then 'Discovery'
4
when "status_name" in ('Ready for Implementation','Selected for Development','Ready for development') then 'Ready'
5
when "status_name" in ('Implementation','In Progress') then 'Delivery'
6
when "status_name" in ('Deployed','Evaluation') then 'Adoption'
7
when "status_name" in ('Cancelled','Done') then 'Done'
8
when "status_name" in ('Rejected') then 'Rejected'
9
when "status_name" in ('On Hold') then 'On Hold'
10
else 'UNKNOWN status:'||"status_name"
11
end
